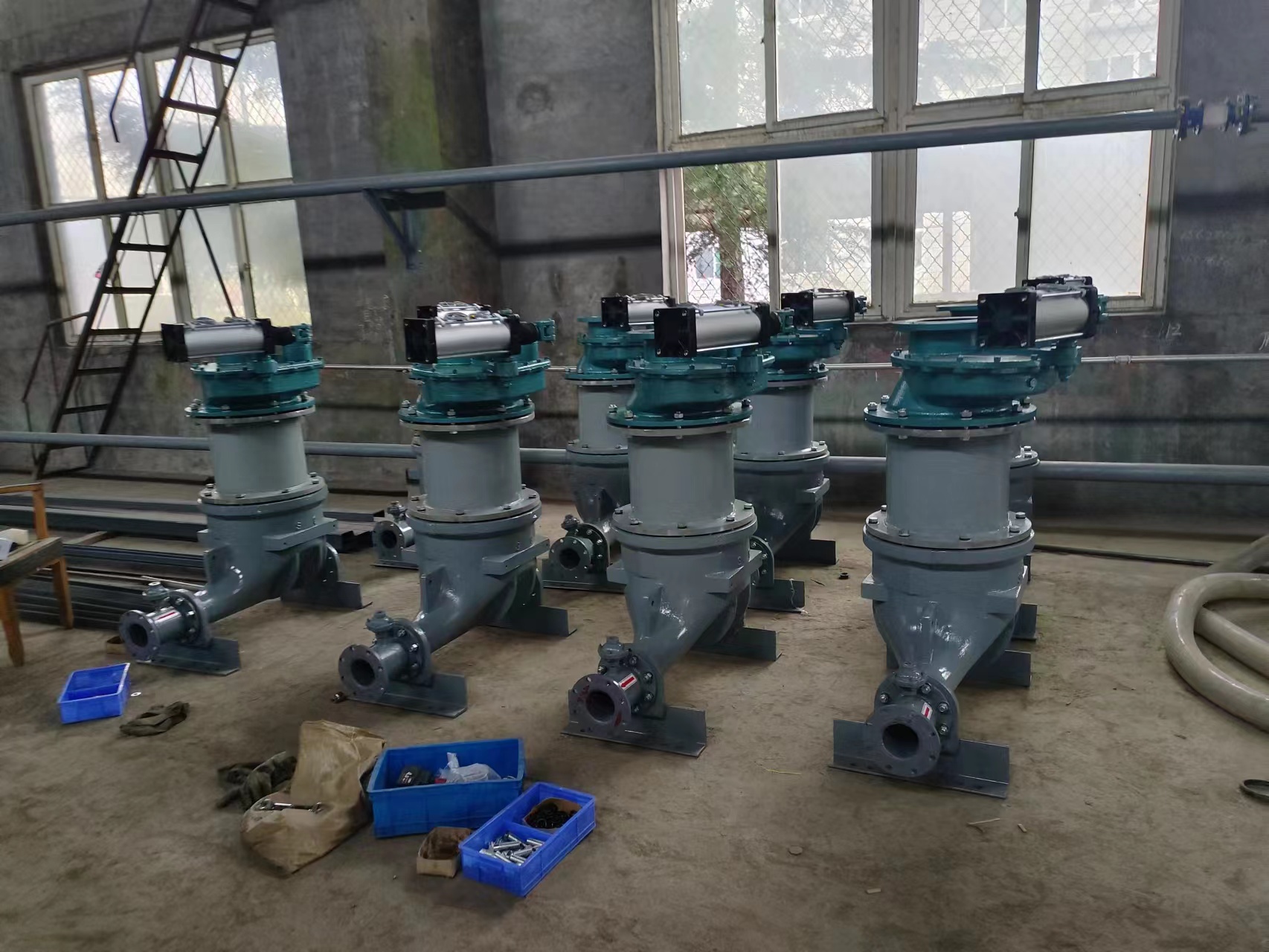

一、安裝前準備工作
1
設備選型核查
Equipment selection verification
在安裝前必須嚴格核對除塵器型號規格與水泥罐倉的匹配性
Before installation, it is necessary to strictly check the compatibility between the dust collector model and specifications and the cement tank compartment, including key parameters such as processing air volume and filtration area, to ensure that the equipment performance meets the requirements of the working conditions. At the same time, it is necessary to check whether the appearance of the equipment is intact and whether there is any transportation damage to the core components such as the internal filter bag.
工具材料準備
Preparation of tools and materials
安裝需配備完整的工具套裝:包括不同規格的扳手套裝(8-19mm)
Installation requires a complete set of tools, including wrench sets of different specifications (8-19mm), electric screwdrivers, level gauges, sealant guns, and other professional tools. In terms of materials, it is necessary to prepare high-temperature resistant sealant, 304 stainless steel bolt sets (including flat pads and spring washers), explosion-proof electrical wiring terminals, etc.
現場環境準備
On site environment preparation
安裝區域需進行徹底清理
The installation area needs to be thoroughly cleaned, using an industrial vacuum cleaner to remove dust from the top of the tank compartment. Set up isolation and warning areas to avoid cross operation affecting installation quality. Prepare temporary shelter facilities for rain and dust prevention to ensure that the installation process is not affected by weather.
二
2、 Standardized installation process
定位測量
Positioning measurement
采用全站儀進行精確定位
Using a total station for precise positioning, determine the installation coordinates of the dust collector based on the CAD drawings of the tank structure. Consider the maintenance space requirements (it is recommended to retain a circular channel of ≥ 800mm) and avoid key components such as the safety valve on the top of the warehouse.
支架安裝
Bracket installation
選用δ=8mm碳鋼支架
,采用M16化學錨栓固定。安裝時使用激光水平儀校準Choose a carbon steel bracket with δ=8mm and fix it with M16 chemical anchor bolts. During installation, a laser level should be used for calibration, and the horizontal deviation should be controlled within 3 ‰. The welding area needs to undergo rust prevention treatment and complete a 24-hour load-bearing test.
管道連接
Pipeline connection
(1)進氣管道采用法蘭連接,石棉墊片需做浸油處理
(1) The intake pipeline adopts flange connection, and the asbestos gasket needs to be treated with oil immersion
(2)出風管道安裝膨脹節補償熱位移
(2) Installation of expansion joints to compensate for thermal displacement in the air outlet duct
(3)所有接口需進行氣密性檢測(0.05MPa保壓測試)
(3) All interfaces need to undergo air tightness testing (0.05MPa pressure holding test)
主體安裝
Main installation
吊裝時使用專用平衡梁
Use a dedicated balance beam during lifting, and tighten the bolts with a torque wrench after positioning (torque values refer to GB/T3098.1). The final verticality deviation is ≤ 2mm/m.
電氣安裝
Electrical installation
(1)按IEC標準敷設阻燃電纜
(1) Lay flame-retardant cables according to IEC standards
(2)防爆區域需使用ExdⅡBT4等級電器元件
(2) Explosion proof areas require the use of Exd Ⅱ BT4 grade electrical components
(3)接地電阻測試值≤4Ω
(3) Grounding resistance test value ≤ 4 Ω
